Site Update Reports for the Year 2020



December 29, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 12/17/20 through 12/27/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of third phase of Parcel 1 soil remediation area.


Backfilling of third phase of Parcel 1 soil remediation area.



December 11, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 12/03/20 through 12/09/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of third phase of Parcel 1 soil remediation area.


Backfilling behind Parcel 2 bulkhead.



December 4, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 11/19/20 through 12/02/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Excavation of third phase of Parcel 1 soil remediation area and installation of bracing.


Backfilling of Parcel 2 hydraulic relief system.



November 20, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 11/12/20 through 11/18/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of third phase of Parcel 1 soil remediation area and installation of bracing.


Installation of Parcel 2 hydraulic relief system.



November 13, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 11/05/20 through 11/11/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of third phase of Parcel 1 soil remediation area.


Installation of Parcel 3 hydraulic relief system.



November 6, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 10/29/20 through 11/04/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Backfilling second phase of Parcel 1 soil remediation area and preparations for relocation of temporary membrane structure.


Backfilling behind the Parcel 3 bulkhead.



October 30, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 10/22/20 through 10/28/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Backfilling second phase of Parcel 1 soil remediation area.


Installation of Parcel 3 hydraulic relief system.



October 23, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 10/15/20 through 10/21/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC).  On 10/21/20, there was one 15-minute level above the Action Limit for Particulate Matter (PM-10) [smoke from welding adjacent to gas shaft] within the eastern Site boundary along the Gowanus canal.  The welding activity was limited and was stopped when the Action Level alert was received.  Welding operations were reconfigured prior to resuming activities.  Additionally, no dust was observed leaving the Site during this period.  No additional levels above the 15-minute Action Limit for PM-10 occurred during the reporting period.


Backfilling second phase of Parcel 1 soil remediation area.


Installation of Parcel 3 hydraulic relief piping.



October 16, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 10/08/20 through 10/14/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation.


Installation of Parcel 3 bulkhead tie back system.



October 9, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 10/01/20 through 10/07/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation.


Installation of drainage fill behind Parcel 3 bulkhead.



October 2, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 9/24/20 through 9/30/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation.


Backfilling of Parcel 3 bulkhead tie back system.



September 25, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 9/17/20 through 9/23/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation and installation of support of excavation.


Installation of Parcel 3 bulkhead tie back system.



September 18, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 9/10/20 through 9/16/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation and installation of support of excavation.


Installation and backfilling of Parcel 3 bulkhead tie back system.



September 11, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 9/3/20 through 9/9/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation.


Installation of Parcel 3 bulkhead tie back system.



September 4, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 8/27/20 through 9/2/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Second phase of Parcel 1 soil remediation area excavation.


Load out of stockpiled material on Parcel 3.



August 28, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 8/20/20 through 8/26/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 3 bulkhead tie back system.


Relocation of temporary membrane structure on Parcel 1.



August 21, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 8/13/20 through 8/19/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 3 bulkhead tie back system.


Installation of steel sheeting for support of excavation for Parcel 1 soil remediation areas.



August 14, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 8/6/20 through 8/12/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 3 bulkhead tie back system.

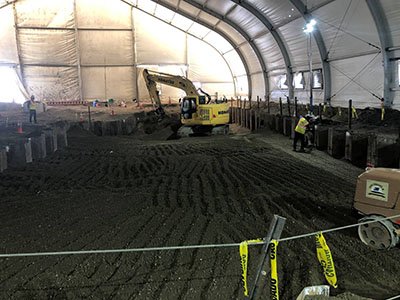

Parcel 1 soil remediation excavation within temporary membrane structure.



August 7, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 07/30/20 through 8/05/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC).  On 7/30/20, there was one 15-minute level above the Action Limit for Particulate Matter (PM-10) [smoke from welding at gas shaft by National Grid Gas] within the eastern Site boundary along the Gowanus canal.  The welding activity was limited and was stopped when the Action Level alert was received.  National Grid Gas reconfigured welding operations prior to resuming activities.  Additionally, no dust was observed leaving the Site during this period.  No additional levels above the 15-minute Action Limit for PM-10 occurred during the reporting period.


Installation of Parcel 3 bulkhead anchor wall sheets and tie back system.


Grading for additional temporary membrane structure locations on Parcel 1.



July 31, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 7/23/20 through 7/29/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Removal of Parcel 3 steel sheet piles installed for support of excavation.


Installation of temporary membrane structure on Parcel 1.



July 24, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 7/16/20 through 7/22/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation for installation of anchor wall tie back system on Parcel 3.


Installation of temporary membrane structure and steel sheeting for support of excavation on Parcel 1.



July 17, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site (the “Site”) to address MGP related impacts in accordance with the New York State Department of Environmental Conservation (NYSDEC) approved design. The cleanup activities are being performed with oversight by the “NYSDEC”.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021. Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 7/09/20 through 7/15/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of frame for temporary membrane structure on Parcel 1.


Installation of Parcel 3 bulkhead headwall.



July 10, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continued community air monitoring.  For the period 7/02/20 through 7/08/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC).  On 7/02/20, there was one 15-minute level above the Action Limit for Particulate Matter (PM-10) [smoke from chainsaw] within the northwestern Site boundary near the intersection of Smith and 5th Streets.  The chainsaw activity was limited and was completed when the Action Level alert was received.  Additionally, no dust was observed leaving the Site during this period.  No additional levels above the 15-minute Action Limit for PM-10 occurred during the reporting period.


Completed controlled low strength material gravity wall for support of excavation on Parcel 1.


Installation of Parcel 3 bulkhead anchor wall sheets.



July 3, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 06/25/20 through 07/01/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 3 bulkhead headwall.


Installation of Parcel 1 controlled low strength material gravity wall for support of excavation.



June 26, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 6/18/20 through 6/24/20 there was no 15-minute Action Limit exceedances for Total Volatile Organic Compounds (TVOC).  On 6/19/20, there was one 15-minute Action Limit exceedances for Particulate Matter (PM-10) [smoke from welding] within the southwestern Site boundary along the Gowanus Canal.  The welding activity was stopped for the day following receipt of the 15-minute Action Limit exceedance.  Additionally, no dust was observed leaving the Site during this period.  No additional 15-minute Action Limit exceedances for PM-10 occurred during the reporting period.


Installation of Parcel 1 support of excavation with noise mitigation wall in background.


Removal of Parcel 3 temporary membrane structure.



June 19, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 06/10/20 through 06/17/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 1 controlled low strength material gravity wall.


Removal of Parcel 3 temporary membrane structure.



June 12, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 06/04/20 through 06/12/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 1 controlled low strength material gravity wall.


Backfilling of Parcel 3 soil remediation area.



June 5, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

Overview:

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 05/28/20 through 06/03/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Installation of Parcel 2 bulkhead wall.


Parcel 1 soil remediation area controlled low strength material gravity wall excavation.



May 29, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 05/21/20 through 05/27/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Installation of Parcel 2 bulkhead wall.


Excavation of Parcel 3 soil remediation area.



May 22, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 05/14/20 through 05/20/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation and backfilling of Parcel 2 bulkhead wall.


Backfilling of portion of Parcel 3 soil remediation area.



May 15, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 05/07/20 through 05/13/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 2 bulkhead wall.


Backfilling of portion of Parcel 3 soil remediation area.



May 8, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 04/30/20 through 05/6/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation and backfilling of Parcel 2 bulkhead wall.


Excavation of Parcel 3 soil remediation area.



May 1, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 04/23/20 through 04/29/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Installation of Parcel 2 bulkhead wall.


Installation of bracing within Parcel 3 soil remediation area.



April 24, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 04/16/20 through 04/22/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].



Removal of steel sheeting on Parcel 3.


Installation of Parcel 2 bulkhead king pile.



April 17, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to be completed by the middle of 2021.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 04/09/20 through 04/15/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Relocation of temporary membrane structure.


Backfilling behind the Parcel 2 bulkhead.



April 10, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 04/02/20 through 04/08/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Preparing temporary membrane structure for relocation.


Backfilling behind the Parcel 2 bulkhead.



April 3, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 3/26/20 through 4/01/20 there was no 15-minute Action Limit exceedances for Total Volatile Organic Compounds (TVOC).  On 3/30, there were two 15-minute Action Limit exceedances for Particulate Matter (PM-10) [dust] within the western Site boundary along the Gowanus Canal.  Additional dust mitigation consisting of increased water application in the work area was implemented immediately following notification of the elevated PM-10 concentrations.  No additional 15-minute Action Limit exceedances for PM-10 occurred during the reporting period.



Backfilling of the Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



March 27, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 03/19/20 through 03/25/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Backfill and removal of bracing from Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



March 20, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 03/12/20 through 03/18/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation and backfill of Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



March 13, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 03/05/20 through 03/11/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



March 6, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 02/27/20 through 03/04/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



February 28, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 02/20/20 through 02/26/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Excavation of Parcel 3 soil remediation area.


Installation of the Parcel 2 bulkhead.



February 21, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 02/13/20 through 02/19/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of Parcel 3 soil remediation area.


Selective demolition of the Parcel 2 bulkhead.



February 14, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 02/06/20 through 02/12/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].






Backfilling of the Parcel 3 soil remediation area.


Mobilization of crane barge for Parcel 2 bulkhead installation.



February 7, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 01/30/20 through 02/05/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].




Excavation of the Parcel 3 soil remediation area.


Pre-drilling the sheeting alignment for the Parcel 1 soil remediation area.



January 31, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 01/23/20 through 01/29/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of the Parcel 3 soil remediation area.


Selective demolition of Parcel 2 bulkhead.



January 24, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 01/16/20 through 01/22/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Excavation of the Parcel 3 soil remediation area.


Selective demolition of Parcel 2 bulkhead.



January 17, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 01/09/20 through 01/15/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Parcel 2 bulkhead selective demolition.


Pre-drilling the sheeting alignment for the Parcel 1 soil remediation area.



January 10, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 12/26/19 through 01/08/20 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Parcel 2 bulkhead selective demolition.


Parcel 3 tent structure installation and load-out of clean concrete.



January 3, 2020

National Grid’s contractor, Creamer Environmental, is implementing remedial actions at the Citizens former Manufactured Gas Plant (MGP) Site to address MGP Site related impacts in accordance with the NY State DEC approved design.  Mobilization began on July 10, 2019 and the remedial activities are expected to take about 2 years to complete.  The cleanup activities are being performed with oversight by the New York State Department of Environmental Conservation (NYSDEC).  Community air monitoring and vibration monitoring are being conducted during this project.

On-going activities:

Recently completed activities:

Upcoming work activities:

Community Air Monitoring Plan Summary

Continuous community air monitoring is on-going.  For the period 12/19/19 through 12/25/19 there were no levels above the 15-minute Action Limit for Total Volatile Organic Compounds (TVOC) or Particulate Matter (PM-10) [dust].


Parcel 2 bulkhead selective demolition.


Parcel 3 tent structure installation.
